Skip to content

Risk Register

github-actions[bot] edited this page Oct 17, 2026 · 2 revisions

Risk Register — a project-scoped registry of risks (Refs #1930, parent #1066)

Net-new for 2.0.1: TestLink 1.9.20 has no first-class, editable risk registry. The only risk-shaped artifacts are the vestigial risk_assignments / tc_risk tables (schema only, no controller) and the read-only risk-coverage dashboard already modernized under Risk-Based Testing (#1277), which owns the separate risk.* i18n namespace and derives levels from importance × urgency. This module delivers the missing CRUD half of the parent "Risk-Based Testing" feature: a project-scoped register where a team can record each risk — name, impact, likelihood, severity, priority, a derived risk level, status, owner, mitigation and free notes — and optionally link it to a requirement and a test case.

Entry point

  • Screen: gui/templates/risk/riskRegister.html (Dashio standalone HTML/JS/CSS)
  • BFF API: api/risk/index.php
  • ASIDE menu: section Risk Register (icon fas fa-exclamation-triangle), single project-scoped item; shown whenever the user can read test cases (mgt_view_tc or mgt_modify_tc).
  • URL of the action: $actions->riskRegister (lib/functions/common.php).
  • Server label: $TLS_title_risk_register in all 19 locale/*/strings.txt.
  • No legacy controller/template to retire — the module is net-new.

Why a second "risk" screen

Risk-Based-Testing (#1277) is a read-only analytics dashboard: it rates existing test cases (likelihood × impact) and reports coverage and metrics by risk level. This screen is the registry of record: free-form project risks with their own lifecycle (open / mitigated / accepted / closed) that are not tied to a test case's rating. The two therefore use distinct i18n namespaces (risk.* vs riskreg.*) so their labels never bleed into each other.

What the screen does

Area Behaviour
Metric tiles Total, linked, critical, high, medium and low — recomputed from the list on every load
Filters Level (critical / high / medium / low) and status (open / mitigated / accepted / closed); explicit no-match empty state
Registry table DataTable with Name / Level / Impact / Likelihood / Status / Linked to / Updated / Actions
New / Edit Modal form: name, impact, likelihood, severity, priority (1–5 each), status, owner, mitigation, linked requirement, linked test case, notes. A live preview shows the derived level (impact × likelihood); a duplicate name is rejected with duplicate_name (409)
Details Read-only modal showing every field, the level product and the linked refs
Delete Bootstrap confirm ({name} interpolated); removes the risk
Locale TLi18n locale switcher; every label/placeholder/message is a key
State cards riskreg.noProject / riskreg.noRight / riskreg.errTitle machine-code states for 400/401/403/404

The derived level is computed from impact × likelihood: 1–4 low, 5–9 medium, 10–14 high, 15–25 critical. Severity and priority are free-form scores kept for the record; they do not affect the derived level.

Data model

One table, created lazily with CREATE TABLE IF NOT EXISTS so a freshly imported database works unchanged; the DDL is also mirrored in install/sql/mysql/testlink_create_tables.sql and the name is whitelisted in lib/functions/object.class.php:

  • tc_risks — one row per risk. testproject_id scopes the row to a test project; name, impact, likelihood, severity, priority, status, owner, mitigation, notes are the definition; requirement_id and tcase_id are optional links (validated to belong to the same project and to be of the expected node type — 7/8 requirement vs 3 test case); created_by, creation_ts and update_ts provide a light audit trail. Indexes: idx_risks_project (testproject_id) and idx_risks_status (testproject_id, status).

BFF API — api/risk/index.php

Session auth + same-origin CSRF guard (bffSameOriginGuard), JSON in/out. Rights are checked on the addressed test project before it is resolved (the #1697 lesson: no existence oracle — an unknown project and a forbidden project both fail closed):

Route Rights
GET ?action=init&tproject_id=N → {context, domains, stats, refs, items} read
GET ?action=list&tproject_id=N → {items} read
POST ?action=save {tproject_id, id?, name, impact, likelihood, severity, priority, status, owner, mitigation, requirement_id?, tcase_id?, notes} write
POST ?action=delete {tproject_id, id} write
  • read = mgt_view_tc or mgt_modify_tc on the project
  • write = mgt_modify_tc on the project

Machine codes: not_authenticated (401), no_right (403), no_testproject (400), wrong_method (405), unknown_action (400), name_required (400), bad_status (400), invalid_requirement (400), invalid_tcase (400), duplicate_name (409), risk_not_found (404), bad_id (400), insert_failed (500), save_failed (500), delete_failed (500), tproject_not_found (404). A tproject_id of 0 falls back to the session project (intended).

The refs block of init lists the project's requirements and test cases (recursive CTE over nodes_hierarchy, node_type_id IN (3,7) — test case and requirement) so the modal pickers only ever offer same-project targets.

save with no id creates a new risk (RISK_CREATE); with an existing id it updates it (RISK_SAVE). delete removes it (RISK_DELETE). All three emit AUDIT Event Viewer rows (log_level 16).

i18n

67 riskreg.* keys plus footers.riskRegister in all 10 client bundles (gui/templates/i18n/*.json), plus $TLS_title_risk_register in all 19 server locales (locale/*/strings.txt). ai/verify_i18n_coverage.sh passes (8430 keys, 9/9 bundles). The distinct riskreg.* namespace was chosen precisely to avoid colliding with the 73 pre-existing risk.* keys of the Risk-Based-Testing dashboard.

Verification

Suite Modernize — Issue #1930 in tmp/TLU_Test_Cases.md (16/16). Verified in the browser as admin: tiles, level + status filters and the empty state, create (derived CRITICAL 5 × 4 = 20, both link chips, tiles update, RISK_CREATE audit), the New-modal defaults plus empty-name and duplicate-name (409) validation, details modal, edit (status open→mitigated, update_ts bumped, RISK_SAVE audit), delete confirm→delete (RISK_DELETE audit). The 403 no-right state was exercised with a dedicated right-less user (main area hidden, no New button) and the 404 no-project state. German and Romanian locales render translated labels (Risikoregister, Registrul riscurilor). BFF error paths exercised over curl (401/403/404/400/405/409). The console is clean and the Event Viewer shows only the intended AUDIT rows (no new Error/Warning). A DataTable re-init bug (stacked header aria-label) was found while testing and fixed.

Post-review fixes (Refs #1930)

A mandatory code review found no security holes but six should-fix items; all were applied before the screen closed:

  1. BFF duplicate race — lib/functions/database.class.php throws from exec_query() on any XHR failure, so the post-insert_id() duplicate guard was dead code. Writes are now wrapped in try/catch; SQLSTATE 1062 answers 409 duplicate_name, anything else 500. (The same latent flaw in api/environments/index.php was filed as bug #1932.)
  2. Linked-node type proof — the membership walk accepted any node in the project (suite, plan, even the project root); it now returns the node's own node_type_id and requires 7/8 for a requirement and 3 for a test case.
  3. Client maxlength lowered to 20000 to match the server cap (was silently truncating at 20000 despite allowing 60000).
  4. Save/delete now bounce to the login page on 401 instead of showing a toast.
  5. The Level column sorts numerically by risk_score (previously alphabetical: critical → high → low → medium); default order is highest-risk first.
  6. A linked id missing from refs shows a #id missing placeholder instead of silently clearing the link on the next save.

Also: icon-only row buttons carry aria-label, and the New button stays hidden until can_modify is known. The DataTable header aria-label stacking affects other destroy+re-init screens and is filed as bug #1931.

Screenshots

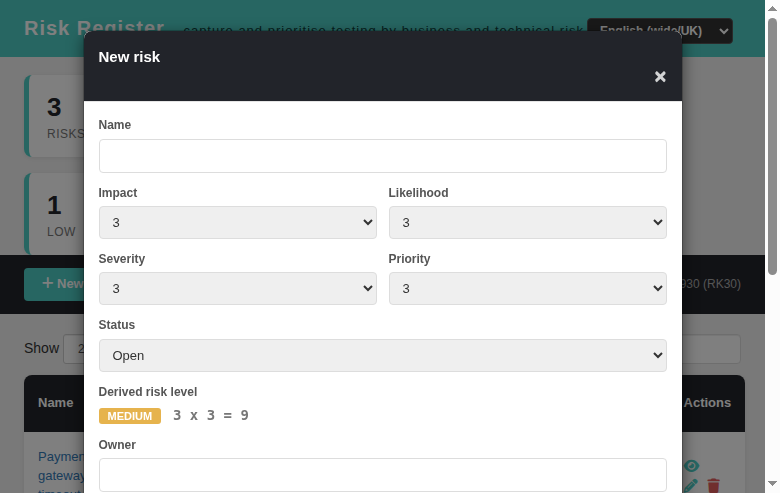

Risk Register — registry with metric tiles, level/status filters and the project chip, sorted highest-risk first Risk Register — create modal with the live derived risk level and the linked requirement/test-case pickers Risk Register — read-only details modal showing the level product and the linked refs Risk Register — registry after the post-review fixes (numeric Level sort, highest risk first)
